How to Handle Underground Pipe Installation in Florida

Master underground pipe installation Florida with expert licensing, permitting, and trenchless methods for reliable utility projects.

What You Need to Know Before Starting Underground Pipe Installation in Florida

Underground pipe installation in Florida is more complex than in most other states — and getting it wrong can stall your entire project.

Here's a quick overview of what's involved:

  • Licensing: Requires a Florida CUC, or Underground Utility and Excavation, license.
  • Pipe types: Water, sewer, stormwater, and fire lines each have different material rules.
  • Installation methods: Common options include open-trench, HDD, auger boring, and pneumatic missile boring.
  • Environmental permits: Often required for wetlands, waterbody crossings, and dewatering.
  • Soil challenges: Sandy soils, high water tables, and wet season conditions can affect every project.
  • Fire protection limits: Utility contractors can install fire piping up to 5 feet from the building.

Florida's combination of high water tables, sandy and clay-layered soils, strict environmental regulations, and hurricane season creates real risks for developers and general contractors who don't plan ahead. A missed permit, an unlicensed subcontractor, or poor trench compaction can mean failed inspections, costly rework, and project delays that ripple through your entire schedule.

I'm Don Larsen of Foshee Construction Co., LLC — a site development contractor serving Central Florida since 1994 with deep hands-on experience in underground pipe installation in Florida, from grading and excavation through full utility infrastructure. In the sections below, I'll walk you through everything you need to know to get this work done right the first time.

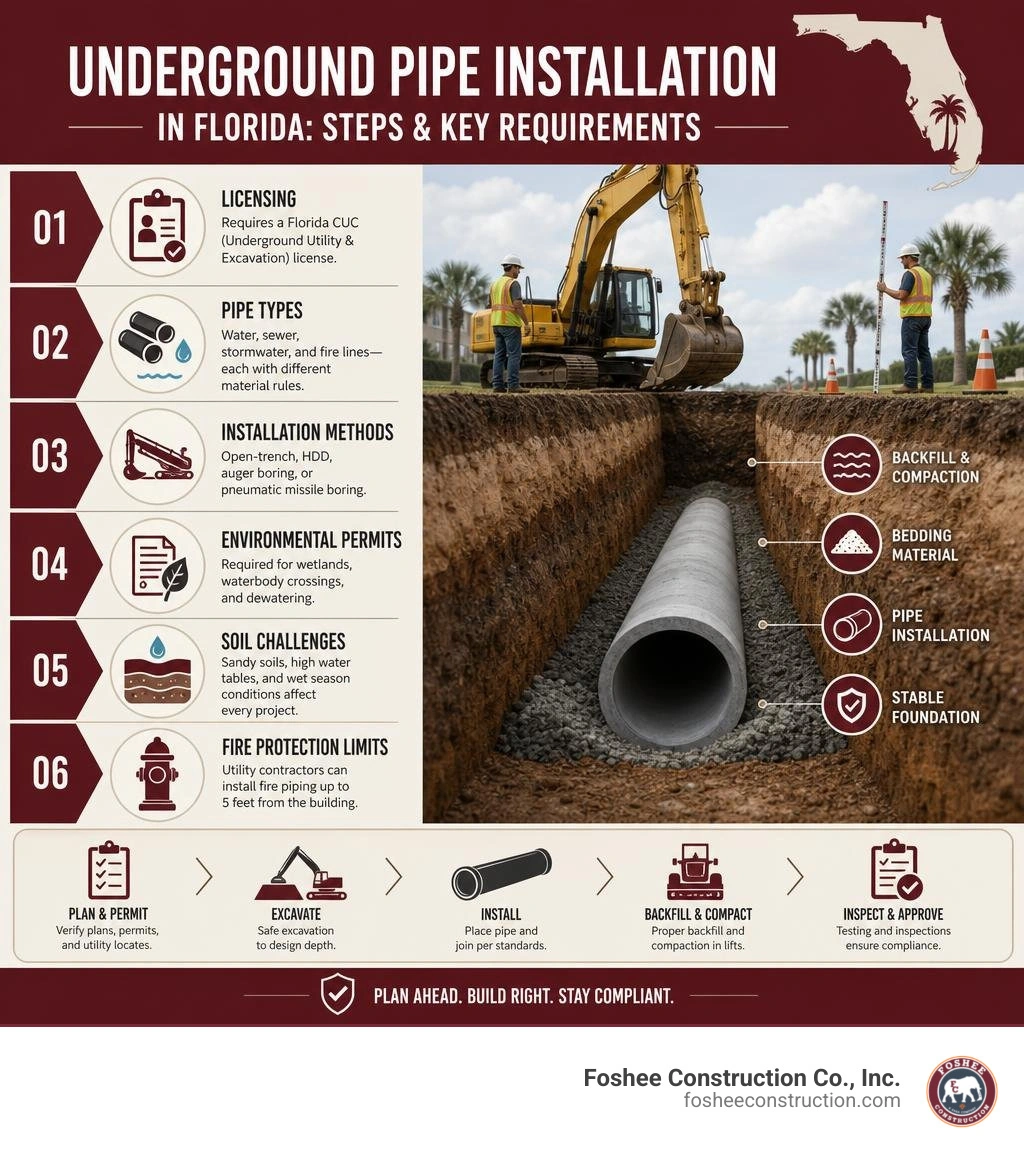

Steps and key requirements for underground pipe installation in Florida overview infographic infographic

Simple underground pipe installation florida glossary:

Before a single bucket of dirt is turned over in Florida, you must navigate the state's strict licensing and regulatory boundaries. Operating without the correct license is not only illegal, but it also exposes property owners and general contractors to massive liabilities and failed building inspections.

In Florida, underground utility work is heavily regulated by the Department of Business and Professional Regulation (DBPR). The primary credential required for this work is the Certified Underground Utility and Excavation Contractor (CUC) license. Hiring qualified utility installation contractors who hold this active credential is the first step toward a compliant project.

Licensing Requirements for Florida Utility and Fire Contractors

To obtain a Florida CUC license, an applicant must prove substantial, verifiable experience in the field. This includes demonstrating hands-on work with main sanitary sewer collection systems, main water distribution systems, and storm sewer collection systems.

The licensing process requires passing two rigorous exams:

  1. The Business and Finance Exam: A 6.5-hour, 120-question test covering bookkeeping, bidding, contract management, and Florida lien laws.
  2. The Underground Utility Trade Knowledge Exam: A 5-hour, 80-question test covering excavation safety, trench backfilling, pipe jointing, traffic control, and equipment operations.

Additionally, contractors must secure comprehensive liability insurance, property damage insurance, and workers' compensation coverage (or an approved exemption) within 30 days of their license being issued.

This license allows us to perform open-cut excavations and utilize trenchless technologies like directional boring, wet/dry taps, slip lining, and empty conduit installations. However, there are strict legal boundaries regarding where a utility contractor's work ends and where a specialized fire protection contractor's work must begin.

Historically, the division of labor between underground utility contractors and fire protection contractors has been a source of confusion and legal disputes. Fortunately, legislative updates have cleared up these boundaries.

The passing of CS/HB 869 (which went into effect on July 1, 2025) expanded and clarified the scope of work for underground utility contractors regarding fire protection systems.

Under current law:

  • Underground Utility Contractors (CUC): Are legally permitted to install piping that is integral to a fire protection system up to a point within five (5) feet of the building or structure where the system will be located.
  • Fire Protection System Contractor Vs: Take over the installation from that 5-foot perimeter mark, installing the piping up to the fire riser inside the building. Their work legally ends no more than 1 foot above the finished floor.

This clear distinction prevents jurisdictional overlap and ensures that high-pressure fire mains are installed safely and in accordance with both the Florida Building Code and the Florida Fire Prevention Code. When laying utility lines near protected water resources, contractors must also operate within the rules outlined in Fla. Admin. Code Ann. R. 62-330.453 - General Permit for Installation, Maintenance, Repair, and Removal of Underground Utility Lines , which dictates how utility corridors must be managed to protect Florida's delicate ecosystems.

Common Types of Underground Piping Systems and Materials

Different utility systems require different pipe materials to handle specific pressures, chemical compositions, and environmental stressors. In Central Florida, we commonly install four primary types of underground piping systems:

  • Potable Water Lines: Deliver clean drinking water under pressure.
  • Sanitary Sewer Lines: Transport wastewater via gravity flow, vacuum systems, or pressurized force mains.
  • Stormwater Systems: Manage heavy rain runoff using gravity-fed pipes and catch basins.
  • Dedicated Fire Lines: High-pressure mains feeding commercial fire sprinkler systems.

Choosing the right material is essential for system longevity. The most common materials used in modern Florida utility projects include:

  • Polyvinyl Chloride (PVC): Highly popular for its corrosion resistance, ease of installation, and cost-effectiveness. It is widely used for gravity sewers, water mains, and force mains.
  • Ductile Iron Pipe (DIP): Used in high-pressure applications, areas with heavy surface traffic loads, or where specific municipal codes mandate its use. Ductile iron often requires specific city or county approval when used for sewer lines due to potential corrosion from sewer gases.
  • High-Density Polyethylene (HDPE): Known for its extreme flexibility and seamless joints. It is the gold standard for trenchless installations. You can read more about its benefits in our guide on HDPE Pipe Underground Utilities.

For pressurized systems, including potable water networks, ensuring material compatibility and proper depth of cover is critical. For a deeper dive into these requirements, see our article on planning a buried water line.

Water, Sewer, and Stormwater Standards

All underground piping installations must adhere strictly to the American Water Works Association (AWWA) standards and local municipal specifications.

Gravity sewer systems require extreme precision during installation because they rely entirely on slope to move waste. Even a minor dip or "belly" in the pipe can cause solids to collect, leading to chronic blockages. Because of this, Florida municipalities enforce strict maximum allowable depression limits during testing:

  • For an 8-inch diameter gravity sewer pipe, the maximum allowable depression is 1 inch.
  • For a 10-inch diameter gravity sewer pipe, the maximum allowable depression is 1.25 inches.

Any deviation beyond these limits requires the contractor to excavate, re-grade, and re-lay the pipe.

Additionally, underground utility contractors must occasionally coordinate with other fuel and gas transmission lines. If your project requires managing or crossing gas infrastructure, it is vital to work with specialized gas line contractors near me to prevent dangerous utility strikes.

Technical Requirements and Best Practices for Florida Pipeline Installation

Installing underground pipes in Florida's unique terrain requires strict adherence to engineering standards. It is not as simple as digging a ditch, dropping a pipe, and throwing the dirt back in.

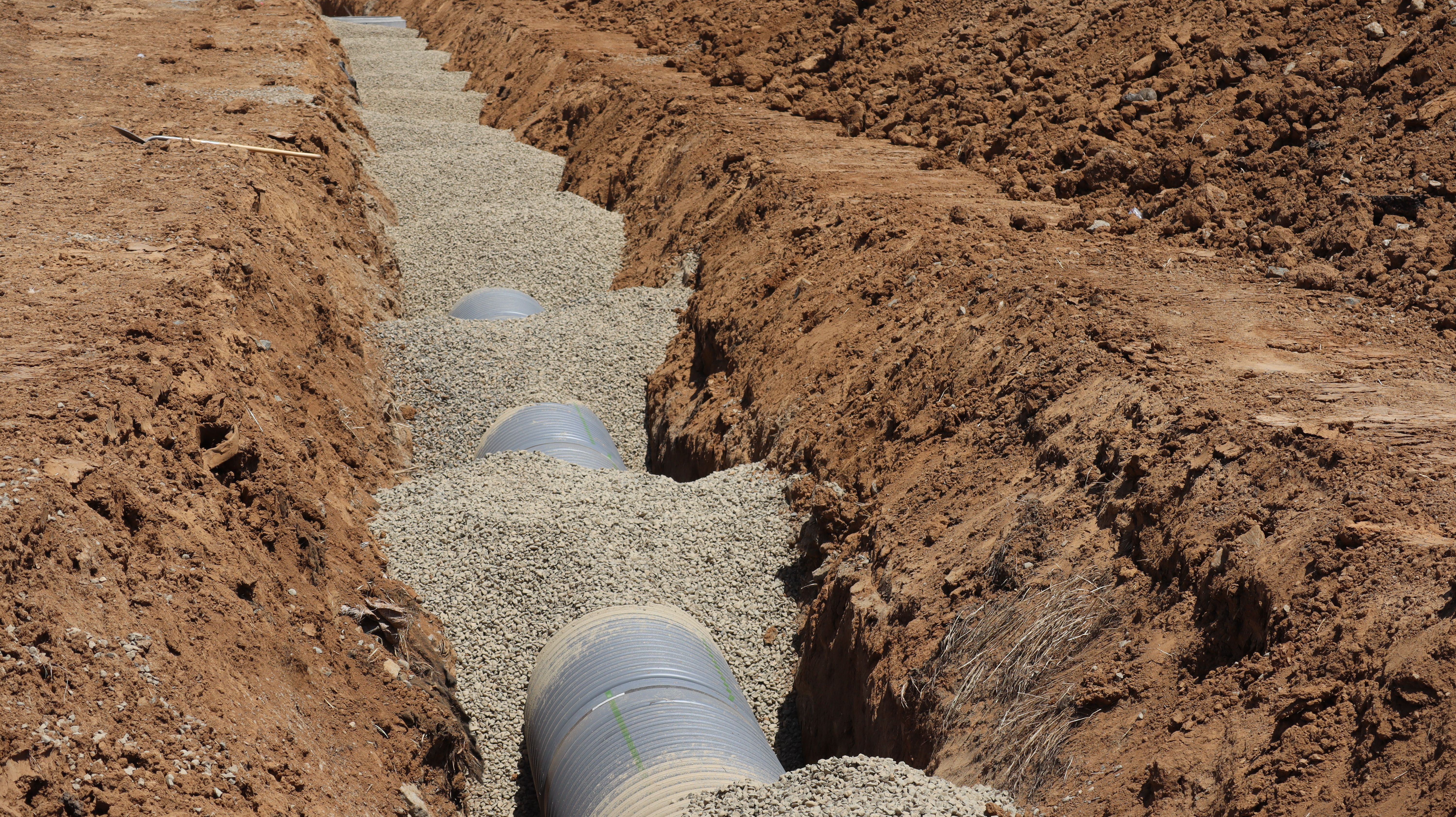

Trench excavation and pipe bedding process in Florida sandy soil

To ensure structural integrity, pipelines must be installed using standardized municipal guidelines, such as those detailed in the Technical Specifications for Laying and Jointing Buried Pipelines.

Bedding, Backfill, and Joint Assembly

The foundation of any successful pipeline is the trench bedding. Pipes must be laid in dry trenches with a stable bottom. If groundwater is present, we must implement dewatering systems to keep the trench dry during installation.

  1. Bedding: We use select, clean fill bedding material (free of large rocks, organic debris, or clay lumps) to provide continuous, uniform support along the entire length of the pipe barrel. Bell holes must be excavated at each joint so the pipe weight rests on the barrel, not on the joints.
  2. Jointing and Assembly: Mechanical joints must be assembled using torque wrenches to prevent over-tightening or joint failure. The torque specifications for mechanical joint bolts are precise:
    • 5/8-inch bolts: 40 to 60 ft-lbs
    • 3/4-inch bolts: 60 to 90 ft-lbs
    • 1-inch bolts: 70 to 100 ft-lbs
    • 1-1/4-inch bolts: 90 to 120 ft-lbs
  3. Field Cuts: When a pipe must be cut on-site, it must be saw-cut square and perpendicular to the pipe axis. We then bevel the cut end approximately 0.25 inches at a 30-degree angle and remove all sharp edges to prevent damaging the gasket during insertion.
  4. Gasket Care: Gaskets must be stored properly. Any gasket material stored on-site for more than six months must be inspected and approved before we can use it.
  5. Tolerances: The alignment of the pipeline must be highly accurate. The pipe centerline cannot deviate more than 1/2 of the pipe's diameter from the horizontal design plans. The grade (elevation) must be within 6 inches of the established design grade.

Safety, Separation, and Identification Standards for Underground Pipe Installation in Florida

To protect public health, Florida Administrative Code (FAC) rule 62-555.314 establishes strict horizontal and vertical separation requirements between potable water mains and sanitary sewers or reclaimed water lines.

  • Standard Separation: Water mains should ideally be laid with at least 10 feet of horizontal separation from any existing or proposed gravity sewer or force main.
  • Encasement Rules: If a water main must cross a gravity sewer line with less than 12 inches of clear vertical distance, or run parallel with less than 6 feet of separation, concrete encasement or special pipe materials are required. The concrete encasement must extend a minimum of 10 feet on each side of the crossing point to prevent cross-contamination in the event of a leak.

For safety and future maintenance, all buried pipelines must be easily identifiable:

  • Metallized Warning Tape: Must be buried 12 inches below the finished grade directly above the pipeline.
  • Electronic Markers: Must be installed 6 inches above the pipe at all bends, tees, valves, fittings, changes in alignment, and at least every 250 feet along straight runs.

These same high standards of separation and clear marking apply when routing power and communication lines. For more information on this, check out our resources on installing Underground Electrical Conduit and proper Trenching for Electrical Conduit.

Trenchless vs. Traditional Open-Trench Installation Methods

When planning underground pipe installation in Florida, choosing the right excavation method can significantly impact your budget, timeline, and environmental footprint.

  • Open-Trench Excavation

    • Best for: New developments, open fields, and deep gravity sewers
    • Advantages: Lower direct installation cost and straightforward visual inspection
    • Disadvantages: High surface disruption and extensive restoration required
  • Horizontal Directional Drilling (HDD)

    • Best for: Crossings under roads, wetlands, and existing structures
    • Advantages: Minimal surface damage and easier obstacle avoidance
    • Disadvantages: Higher equipment setup costs and risk of frac-outs
  • Auger Boring

    • Best for: Straight-line crossings under railroads and highways
    • Advantages: Highly precise line and grade control, with steel casing installation
    • Disadvantages: Limited to straight paths and requires large excavation pits
  • Pneumatic Missile Boring

    • Best for: Short residential runs, driveways, and sidewalks
    • Advantages: Very fast, small footprint, and cost-effective
    • Disadvantages: Limited to short distances, usually under 50 to 100 feet

If your project is located in Central Florida, working with an experienced local utility contractor is key to navigating our regional soil conditions and selecting the most efficient installation method for your site.

Horizontal Directional Drilling (HDD) and Auger Boring

Horizontal Directional Drilling (HDD) is a steerable, trenchless method that uses a surface-launched rig to install pipes with minimal surface disruption. The process involves drilling a small pilot bore along a designed path, reaming the hole to a larger diameter, and then pulling the continuous pipe (usually HDPE or fusible PVC) back through the borehole.

Auger boring (or jack-and-bore) is a non-steerable method typically used to install steel casing pipes under major highways, railroads, and federally regulated channels. Because it is highly rigid, auger boring is often required by the Florida Department of Transportation (FDOT) to prevent any risk of road settlement. Experienced utility teams utilize specialized boring equipment to ensure these heavy-duty operations are completed safely and in full compliance with state transportation standards.

Pneumatic Missile Boring for Short Runs

For short, direct runs—such as installing a water service line or electrical conduit beneath a paved driveway or concrete sidewalk—pneumatic missile boring is highly efficient.

This method uses a torpedo-shaped tool driven by compressed air to compact and tunnel through the soil, creating a clean path without disturbing the surface. Because Central Florida soils can transition rapidly from loose sand to dense clay, the pneumatic equipment must be carefully calibrated to prevent the boring tool from deflecting off course.

Environmental Permitting and Geographic Challenges in Florida

Florida’s geography presents unique challenges for underground construction. Our high water table and sensitive ecosystems require strict environmental compliance and specialized engineering.

High water table utility dewatering pump setup in Central Florida

Central Florida’s soil composition is highly variable. In Lake County, for example, we regularly deal with sandy topsoil layered over dense clay pockets and limestone substrata. During the wet season (and particularly during hurricane season from June through November), the ground can become completely saturated, making trenches unstable and prone to cave-ins.

Wetland Disturbances and General Permit Conditions

Working near or through wetlands in Florida requires strict adherence to the general permit conditions outlined in Rule 62-330.453 of the Florida Administrative Code. This rule establishes clear environmental limits to protect our state's water resources:

  • Disturbed Corridor: The maximum width of the disturbed corridor in wetlands must not exceed 30 feet for underground utility line installations.
  • Forested Wetlands: The total area of forested wetland disturbance must not exceed 0.5 acres per ten miles of pipeline.
  • Pipe Diameter Limits: The maximum outside diameter of the pipeline (including its casing) must not exceed 30 inches when using directional drilling or jack-and-bore methods under this general permit.
  • Depth of Cover: A minimum depth of cover equal to the greater of either 5 feet, or 5 times the maximum encased diameter of the utility line, must be maintained between the top of the pipe and the wetland soil surface.
  • Navigation Channels: If crossing a federal navigation channel, utilities must be located a minimum of 14 feet below the authorized depth of the channel.
  • Frac-Out Monitoring: During directional drilling, we must continuously monitor drilling fluid pressures. If a "frac-out" (drilling mud escaping into surrounding water or wetlands) occurs, it must be contained immediately and reported to agency staff within 24 hours.
  • Upland Setup: All physical drilling work areas and equipment setups must be located entirely within uplands.

For a complete breakdown of these environmental guidelines, you can reference the full text of Fla. Admin. Code Ann. R. 62-330.453 - General Permit for Installation, Maintenance, Repair, and Removal of Underground Utility Lines .

Dewatering and Soil Stabilization Techniques

Because the water table in many parts of Florida sits just a few feet below the surface, dewatering is a standard phase of almost every underground pipe installation.

To keep trenches dry and safe, we install well-point systems or hydraulic pumps to temporarily lower the local water table around the excavation zone. Managing this water requires permits from the local Water Management District (such as the St. Johns River Water Management District in Lake County). For short-term projects (under 90 days) with low daily pumping volumes, we can often utilize streamlined "No-Notice" dewatering permits.

To keep our workers safe and prevent trench walls from collapsing in wet, sandy soils, we strictly follow OSHA 1926 Subpart P trench safety standards, utilizing trench boxes, aluminum hydraulic shoring, or precise trench benching.

Before we dig, we locate existing utilities using Underground Pipe Locator technology and Ground Penetrating Radar for Underground Utilities to ensure we don't strike unmapped lines.

Project Costs, Timelines, and Contractor Selection

The total cost and timeline of an underground pipe installation in Florida depend on several key variables:

  • Depth of the Pipe: Deeper gravity lines require more excavation, shoring, and extensive dewatering, which increases costs.
  • Soil and Water Conditions: Saturated soils or dense clay layers require specialized handling and slower production rates.
  • Permitting Timelines: Securing environmental and municipal utility permits can take anywhere from a few weeks to several months.

When selecting a utility contractor, look for a partner who understands the local regulatory landscape and soil conditions. At Foshee Construction, we pride ourselves on delivering:

  • Transparent Bids: No hidden fees or unexpected change orders. We price our projects accurately from the start.
  • Disciplined Scheduling: We coordinate our utility installations closely with our grading and site prep phases to keep your overall project on track.
  • Uncompromising Safety: Every trench is dug, shored, and backfilled in strict compliance with state and federal safety standards.

Frequently Asked Questions about Florida Utility Installations

What is the difference between a utility contractor and a fire protection contractor in Florida?

A Certified Underground Utility and Excavation Contractor (CUC) in Florida is licensed to install main water, sewer, and storm systems, including fire protection piping up to 5 feet from a building. A Fire Protection System Contractor V is required to install the remaining piping from that 5-foot mark up to the fire riser inside the building.

What are the environmental limits for trenching in Florida wetlands?

Under Florida's general permit rules, utility installations in wetlands are limited to a disturbed corridor width of 30 feet. Forested wetland disturbance cannot exceed 0.5 acres per 10 miles of pipeline, and a minimum depth of cover of 5 feet (or 5 times the pipe's diameter) must be maintained under wetlands and waterbodies.

How does Florida's high water table affect underground pipe installation?

A high water table requires active dewatering (usually via well-point systems) to ensure trenches are dry and stable before pipes are laid. It also requires contractors to use trench shoring or box systems to prevent wet, sandy soils from collapsing, in compliance with OSHA safety standards.

Conclusion

Successfully executing underground pipe installation in Florida requires a deep understanding of local soils, strict environmental regulations, and precise engineering standards. Whether you are laying gravity sewers, routing water mains, or installing empty conduits, working with an experienced, licensed team is the best way to keep your project on schedule and in compliance.

At Foshee Construction Co., Inc., based in Minneola, Florida, we specialize in complete site preparation, including erosion control, precision grading, and underground utility installations across Lake County and Central Florida. We build reliable, long-term relationships with our clients through transparent bidding, disciplined scheduling, and a continuous focus on safety.

Ready to get your site prepared and your utilities installed correctly? View our completed underground utility projects to see how we deliver high-quality infrastructure solutions across Central Florida.
