Erosion Control Rock Check Dams 101

Learn how erosion control rock check dams reduce velocity, trap sediment & prevent erosion. Design, install & maintain guide.

Why Erosion Control Rock Check Dams Matter on Florida Construction Sites

erosion control rock check dams

Erosion control rock check dams are small barriers of riprap stone placed across a drainage swale, ditch, or channel to slow water down and prevent the channel from eroding.

Here's a quick breakdown of what they do and when to use them:

  • Slow water velocity — Rock check dams reduce the speed of concentrated runoff, cutting down on scour and channel erosion
  • Flatten the effective gradient — A series of dams breaks a steep slope into smaller, gentler steps
  • Trap coarse sediment — Slowing the flow lets heavier particles drop out before they wash downstream
  • Promote infiltration — Temporary ponding behind each dam gives water time to soak into the ground
  • Best for small drainage areas — Most effective in channels draining 10 acres or less

On Florida construction sites, uncontrolled stormwater runoff is one of the fastest ways a project can fall behind. Heavy rain events are frequent, slopes get disturbed during grading, and bare soil erodes quickly. Without velocity control in your swales and ditches, you end up with gullied channels, downstream sediment violations, and costly rework.

Rock check dams are one of the most widely used and cost-effective tools to manage that risk. They're recognized as a best management practice (BMP) by the EPA and are included in erosion and sediment control guidelines across the country.

This guide walks through how they work, how to design and install them correctly, and how to keep them effective throughout your project.

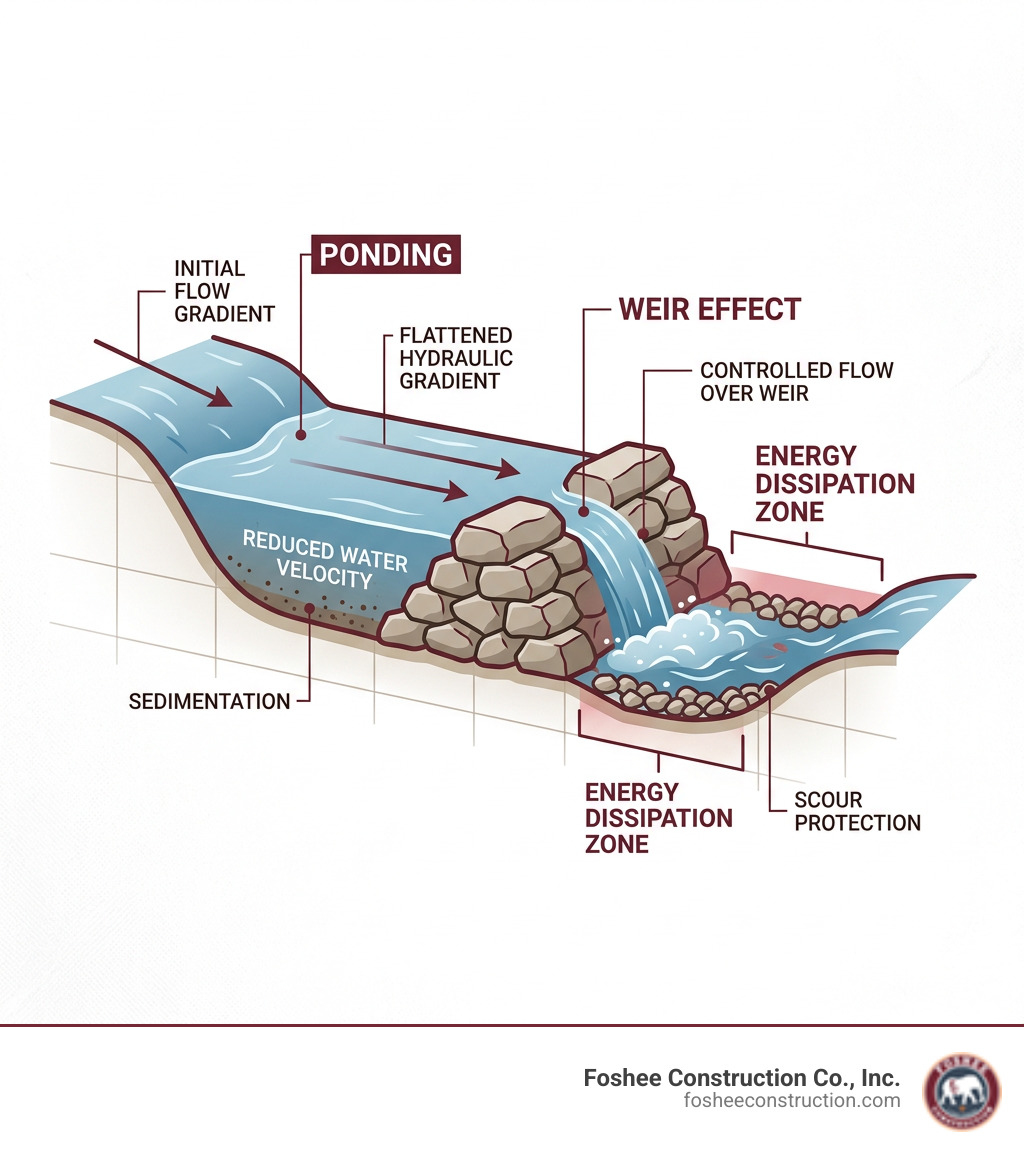

Diagram showing weir effect, energy dissipation zones, and ponding behind a rock check dam in a swale - erosion control rock

How Erosion Control Rock Check Dams Work

At their core, erosion control rock check dams are about energy management. When rain hits a disturbed construction site in Minneola or across Lake County, it gathers in swales and ditches. As that water gains volume and speed, it develops "shear stress"—the physical force that peels soil away from the channel bed.

By placing a rock barrier in the way, we force that water to settle into a pool. This ponding effect does two things: it dissipates the kinetic energy of the moving water and flattens the hydraulic gradient. Instead of one long, steep slide, the water sees a series of flat steps. According to the Minnesota Stormwater Manual on Sediment Control, this process is vital for protecting channels that aren't yet vegetated.

While their primary job is velocity reduction, they also provide a secondary benefit: sediment trapping. As water slows down behind the dam, coarse sediments like sand and gravel settle out. However, we always remind our clients that these aren't primary sediment basins; they are meant to support a larger erosion control plan. They are most effective for drainage areas of 10 acres or less, though for very small sites (under 2 acres), they are even more reliable.

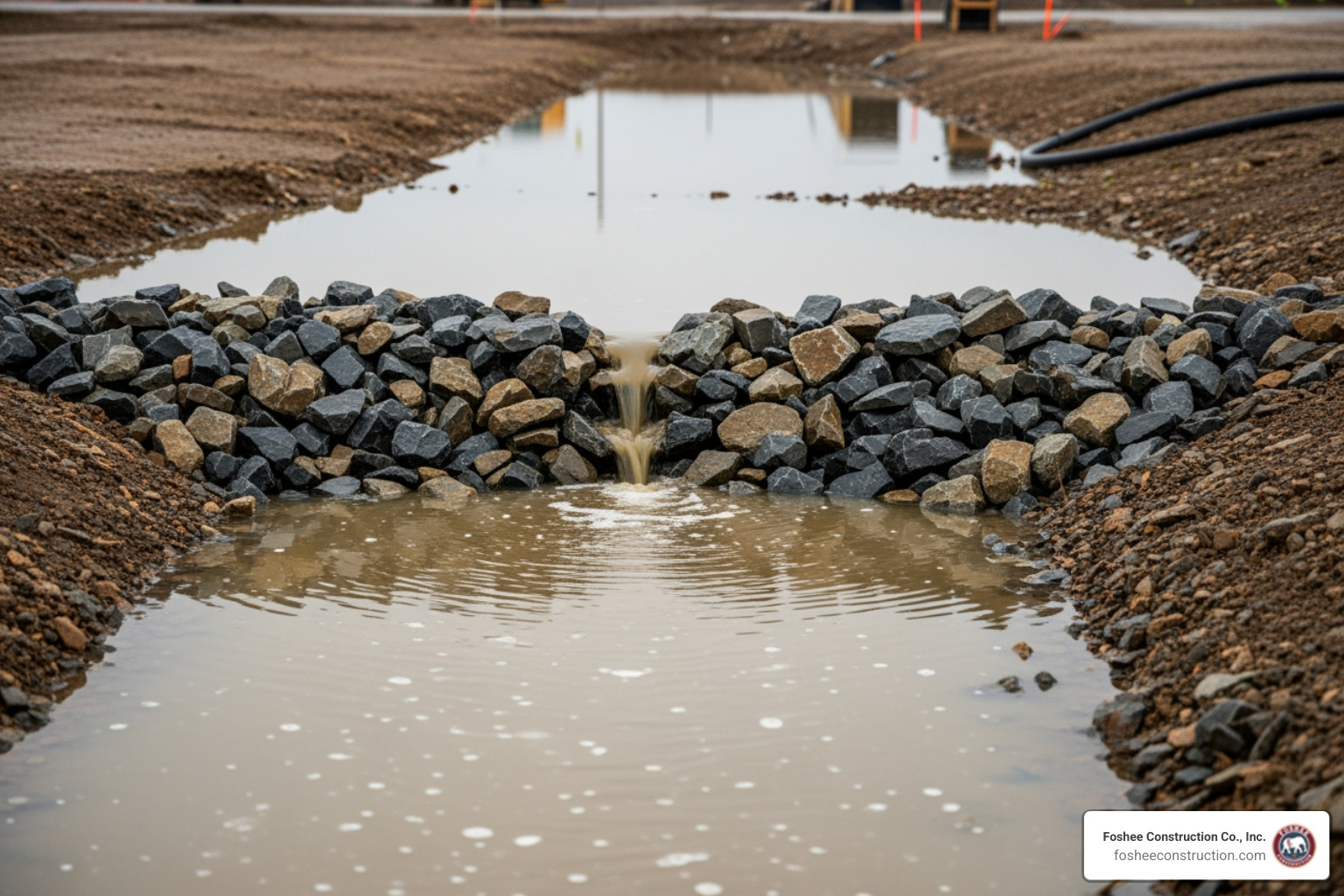

Water ponding behind a riprap barrier in a drainage ditch during a rain event - erosion control rock check dams

Reducing Water Velocity with Erosion Control Rock Check Dams

The "magic" happens through the weir design. A properly built rock check dam isn't just a pile of stones; it’s a shaped structure with a lower center point. This creates a parabolic flow pattern, directing water over the center of the dam rather than around the edges.

If water is allowed to flow around the sides, it will quickly scour the banks, bypassing the dam and making the erosion worse. By keeping the flow in the center, the water's energy is spent falling onto the rock apron below rather than eating away at the soil. This regulation of hydraulic capacity ensures that even during heavy Florida downpours, the channel remains stable.

Key Design Criteria and Material Selection

Choosing the right materials is the difference between a dam that holds and one that washes away during the first afternoon thunderstorm. In our experience at Foshee Construction, using the right stone size and shape is non-negotiable.

Material Standards

  • Stone Sizing: We typically use durable rock riprap between 2 and 15 inches in diameter. A good mix often includes about 30% of 8-inch material to ensure the structure is heavy enough to stay put.
  • Rock Shape: Angular rock is superior to rounded river stone. Angular rocks "lock" together, whereas round stones tend to roll under high pressure.
  • Geotextile Lining: Especially in Florida’s sandy or silty soils, we always recommend placing a non-woven geotextile fabric under the rock. This prevents the water from "piping" underneath the dam and undermining the foundation.
  • Alternatives: While rock is the gold standard for durability, other options like gabions (rock-filled wire baskets) can last decades. For very light, temporary needs, compost filter socks or fiber logs can work, but they don't offer the same heavy-duty velocity reduction as erosion control rock check dams.

Sizing and Spacing for Erosion Control Rock Check Dams

The spacing of your dams depends entirely on the slope of your channel. The goal is the "Toe-to-Crest Rule": the base (toe) of the upstream dam should be at the same elevation as the top (crest) of the downstream dam.

Slope PercentageSpacing (Feet)
2% or less100 feet
3% to 5%67 to 40 feet
6% to 9%33 to 22 feet
10% to 15%20 to 13 feet

The maximum height for these structures is generally 2 feet for drainage areas under 5 acres. If the center is 24 inches high, the outer edges must be at least 6 inches higher to create that necessary weir effect. This "compensation gradient" ensures the water stays in the middle of the ditch.

Step-by-Step Installation Guide

Proper installation is a disciplined process. You can't just dump a truckload of rock into a ditch and call it a day. Here is how we ensure a professional, effective installation:

  1. Site Preparation: Clear the area of large debris. If the channel is already eroding, we may need to smooth the bed first.
  2. Keyway Excavation: This is the most skipped step, but it’s the most important. We excavate a "key" or trench about 6 to 24 inches deep across the channel. This anchors the dam into the ground so water can't blow it out from underneath.
  3. Geotextile Placement: Lay the non-woven fabric into the trench and up the sides of the banks.
  4. Rock Placement: We place the rock by hand or with machinery to ensure complete coverage. Following the EPA Best Management Practices for Check Dams, we ensure the center notch is lower than the sides.
  5. Abutment Stabilization: The rock must extend all the way from bank to bank and be "keyed" into the side slopes at least 6 inches to prevent bypass flow.
  6. Downstream Protection: For permanent or high-flow dams, we often place a small "splash apron" of rock on the downstream side to prevent the falling water from creating a hole.

Maintenance and Decommissioning Protocols

A check dam is only as good as its last inspection. Because these structures trap sediment, they eventually fill up. If a dam is full of dirt, it’s no longer a dam—it’s just a bump in the road that water will jump over.

The 1/2 Height Rule

We follow a strict maintenance schedule: inspect the dams every seven days and after every significant rain event. Once sediment reaches half the height of the dam, it must be removed. This ensures the dam maintains its hydraulic capacity for the next storm.

Common Repairs

  • Stone Displacement: If rocks have moved, they need to be reset. This usually happens if the stones were too small or the flow was higher than designed.
  • Bypass Flow: If you see erosion around the edges, the dam needs to be extended further into the banks.
  • Trash Removal: Leaves and debris can clog the gaps between rocks, causing the dam to act like a solid wall. This can lead to overtopping in areas you didn't intend.

Decommissioning

Once the site is permanently stabilized—meaning the grass is grown in or the permanent liner is installed—the temporary erosion control rock check dams should be removed. We take care to remove all stone so it doesn't interfere with future mowing or flow. Following removal, the area should be immediately seeded and mulched to prevent a new erosion point from forming. For more technical details on long-term care, the Natural Resources Conservation Service Rock Check Dam Guide provides excellent deep-dive data.

Frequently Asked Questions about Rock Check Dams

Can rock check dams be used in live streams?

Generally, no. Erosion control rock check dams are designed for swales, ditches, and "dry" weather channels. Placing any structure in a live, flowing stream requires specific permits from the Florida Department of Environmental Protection (DEP) and often the U.S. Army Corps of Engineers. Doing so without permits can result in heavy fines and environmental damage to aquatic habitats.

How much do rock check dams cost to install?

Costs can vary based on the size of the channel and the type of rock used. According to 2014 data from MnDOT, the average installed cost is around $1,400 per dam. However, material costs alone for a standard 1-foot-deep dam can range from $100 to $400. At Foshee Construction, we pride ourselves on transparent bids, so you’ll know exactly what the materials and labor will cost before we break ground.

What are the common mistakes in rock check dam installation?

The most frequent mistake is the "flat top." If the center of the dam isn't lower than the edges, water will push toward the banks and cause a blowout. Other common errors include failing to "key" the dam into the soil and using silt fence in place of a rock check dam. Silt fence is not designed for concentrated flow and will almost always fail if used as a check dam.

Conclusion

Managing water on a Florida job site requires more than just moving dirt; it requires a disciplined approach to erosion control. Erosion control rock check dams are a reliable, time-tested solution for keeping your site compliant and your channels stable. Whether you are dealing with a small roadside swale in Minneola or a massive site preparation project in Lake County, getting the design and installation right is the key to success.

At Foshee Construction Co., Inc., we specialize in complete site preparation, from underground utilities to grading and erosion control. Our commitment to safety, disciplined scheduling, and reliable relationships with top contractors makes us the preferred choice for Florida developers.

If you need professional assistance with your next project, Request a quote for professional site preparation and erosion control from our team today. We’ll help you keep the water moving—and the soil staying put.
