Everything You Need to Know About Installing Florida Sediment Basins

Master sediment basin installation FL: Design, sizing, step-by-step guide, maintenance & Florida compliance for erosion control.

Why Sediment Basin Installation FL Can Make or Break Your Construction Project

Sediment basin installation fl is a required step on most Florida construction sites — and getting it wrong can mean regulatory fines, project shutdowns, and serious water quality violations.

Here is a quick overview of what you need to know:

Key FactorWhat to Know
When requiredSites disturbing 5+ acres under NPDES/FDEP Construction General Permit
Storage minimum3,600 cubic feet per acre of disturbed drainage area
Install timingBefore any grading or clearing begins
Inspection frequencyWeekly + within 24 hours after any 0.5-inch rain event
Cleanout triggerWhen sediment reaches one-third to one-half of storage capacity
TSS removal target80% or greater

Florida is one of the most demanding states for erosion control. The state receives 40 to 60 inches of rain per year — often in sudden, heavy bursts. South Florida alone leads the entire country in flash flood frequency, according to NOAA. On top of that, construction areas can produce 10 to 20 times more lost soil particles than vegetated land. Without a properly installed sediment basin, that runoff carries pollutants directly into Florida's waterways.

A sediment basin is a temporary engineered pond that slows stormwater runoff and allows suspended soil particles to settle out before the water leaves your site. It is not the same as a catch basin or a simple drainage ditch — it is a designed system with specific sizing, outlet structures, and maintenance requirements tied to state and federal regulations.

I'm Don Larsen, and through my work at Foshee Construction Co., LLC — delivering site development and earthmoving services across Central Florida since 1994 — I've overseen sediment basin installation fl projects ranging from small residential developments to large commercial sites across Lake County and beyond. In this guide, I'll walk you through everything you need to design, install, and maintain a compliant sediment basin in Florida.

Sediment basin lifecycle infographic: site disturbance, runoff capture, sediment settling, clean discharge, maintenance

Understanding Sediment Basins in Florida’s Climate

In Florida, we don't just get "rain"; we get torrential downpours that can drop inches of water in an hour. This unique climate makes understanding the difference between various drainage structures vital for any project in Minneola or Lake County.

While people often use the terms interchangeably, a sediment basin is quite different from a catch basin or a settling basin used in irrigation. A catch basin is typically a small box with a grate (like you see on the side of a road or in a parking lot) designed to trap large debris and whisk water away into a pipe system. A settling basin is often a more permanent fixture used in agricultural settings to remove fine particles before water enters a microsprinkler system.

In contrast, a sediment basin is a large-scale, temporary (or sometimes permanent) impoundment area designed specifically for construction sites. Its job is to hold massive amounts of "muddy" runoff long enough for gravity to pull soil particles to the bottom before the "cleaner" water at the top is discharged.

Comparing Stormwater Structures in Florida

FeatureSediment BasinCatch BasinSettling Basin (Irrigation)
Primary GoalRemove suspended soil from construction runoffCollect surface water and trap large debrisRemove fine silt/sand to prevent emitter clogging
ScaleLarge (usually 2–100 acres drainage)Small (localized inlets)Medium (sized for flow rate)
DurationTemporary (during construction)PermanentPermanent
Target ParticleSilt and Sand (0.002mm - 2.0mm)Trash, leaves, and heavy gravel75-micron particles (200-mesh)

Why Sediment Basin Installation FL is Critical for Site Compliance

If you are breaking ground in Florida, you are likely operating under the National Pollutant Discharge Elimination System (NPDES). The Florida Department of Environmental Protection (FDEP) issues a Construction General Permit (CGP) that mandates strict erosion and sediment control (E&SC) measures.

According to the 4.8SedimentBasin_SB.doc , Florida was actually the first state in the country to require stormwater treatment for all new developments back in 1982. This is because construction sites can lose soil at a rate 10 to 20 times higher than natural land. When that sediment enters our lakes and wetlands, it carries over half of the trace metals found in runoff, devastating local ecosystems.

For sites where 10 or more acres are disturbed at once, a sediment basin is almost always a non-negotiable requirement. Failing to install one—or installing one that doesn't meet the 80% Total Suspended Solids (TSS) removal target—can lead to "Stop Work" orders and massive daily fines.

Environmental Benefits for Florida Properties

Beyond just staying out of legal trouble, proper sediment basin installation fl protects the very land we are building on. In Florida’s humid climate, standing water isn't just a nuisance; it’s a breeding ground for bacteria and a threat to building foundations.

By effectively managing runoff, these basins:

  • Prevent Flooding: They act as a "buffer," holding back peak flows during those famous Florida flash floods.
  • Protect Foundations: Proper drainage prevents soil saturation around new slabs, which can lead to settling and cracks.
  • Improve Water Quality: By trapping silt and pollutants on-site, we keep our local Lake County springs and lakes clear and healthy.

Designing for Florida Conditions: Sizing and Specifications

Designing a basin in Florida isn't a "one size fits all" task. We have to account for the specific soil types and the sheer volume of water our storms produce. The "rule of thumb" in the industry is to provide at least 3,600 cubic feet of storage for every acre of disturbed drainage area.

If you’re working with impaired waters or particularly sensitive environments, that requirement can even jump to a 5-year, 24-hour storm standard.

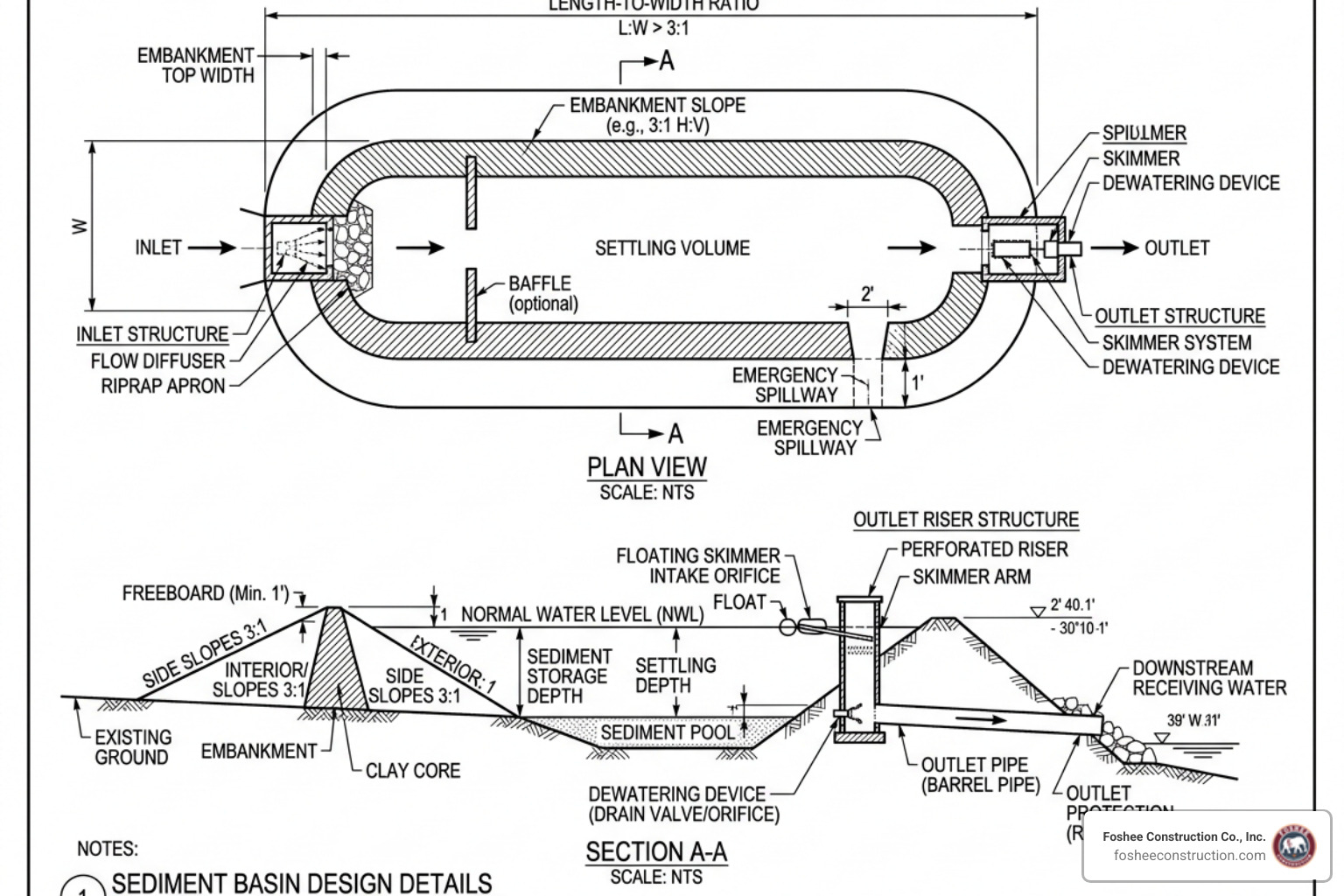

Diagram showing sediment basin design with length-to-width ratio, inlet, and skimmer - sediment basin installation fl

Key Components of an Effective Sediment Basin Installation FL

A hole in the ground isn't a sediment basin. A high-performing system requires several engineered components to work correctly:

  1. The Embankment: This is the "dam" that holds the water. It needs to be constructed with 3:1 side slopes or flatter and compacted in 6-inch layers to prevent failure.
  2. Floating Skimmers: These are the gold standard in Florida. Instead of pulling water from the bottom (where the mud is), a skimmer floats on the surface and drains the cleanest water from the top.
  3. Porous Baffles: Think of these as "speed bumps" for water. Usually made of coir (coconut fiber), they span the width of the basin to reduce turbulence and prevent water from "short-circuiting" (rushing straight from the inlet to the outlet).
  4. Emergency Spillway: This is a rock-lined "exit ramp" designed to handle massive overflows during hurricanes or extreme storms without washing out the entire embankment.
  5. Anti-seep Collars: These are plates attached to the outlet pipe that prevent water from "piping" or seeping along the outside of the pipe through the dam.

For more technical details on these components, you can refer to the Microsoft Word - SedimentBasin_1064.doc .

Sizing Calculations and Flow Rates

We use Stokes' Law to determine how fast particles will settle. In Florida, we generally aim to remove particles as small as 75 microns (about the size of a very fine grain of sand).

  • Surface Area: The larger the surface area, the better the settling. We often use a safety factor of 2 (F=2) to account for turbulence.
  • Length-to-Width Ratio: A basin should be at least twice as long as it is wide (2:1), though 3:1 or even 5:1 is much better. This forces the water to travel a longer path, giving sediment more time to fall to the bottom.
  • Detention Time: The goal is to hold the water for at least 24 to 72 hours. If it drains too fast, the sediment stays suspended and washes away.

Step-by-Step Guide to Sediment Basin Installation FL

At Foshee Construction, we follow a disciplined schedule for installation. You cannot wait until the site is cleared to build your basin; by then, the damage is already done.

Step 1: Pre-Grading Installation

The basin must be the first thing built. Before any mass clearing or grubbing begins, the basin should be functional. This ensures that the very first rain event on the bare soil is captured.

Step 2: Site Excavation and Embankment

We excavate to the designed depth, ensuring we have a "forebay" (a smaller initial pool) to catch the heaviest sand and gravel. The soil used for the embankment must be clean, stable fill, compacted thoroughly.

Step 3: Installing the Outlet Structure

We install the riser pipe and the floating skimmer. It’s critical that the outlet is set at the correct elevation. If it’s too low, you lose storage capacity; if it’s too high, you risk overtopping the dam.

Step 4: Stabilization

As soon as the basin is dug, we stabilize the banks. This usually involves hydroseeding or installing erosion control blankets (RECPs). If the basin walls erode into the basin, you're just filling up your own storage space with mud!

Integrating Basins with Other Erosion Control BMPs

A sediment basin is your "last line of defense," but it works best when paired with other Best Management Practices (BMPs):

  • Silt Fences: These act as "perimeters" to catch sheet flow before it even reaches the basin.
  • Turbidity Curtains: If you are discharging near a lake, these floating barriers provide an extra layer of protection.
  • Vegetation: We aim for 70% vegetative cover on all surrounding slopes to stop erosion at the source.

Materials and Liner Requirements

In some Central Florida locations with very sandy soils, the water might soak into the ground too fast to allow for proper settling. In these cases, we may use:

  • Clay Liners: To prevent rapid infiltration.
  • Geotextiles: To separate rock riprap from the soil.
  • Riprap: Large stones used at the inlet and outlet to prevent scouring.

Maintenance and Common Pitfalls to Avoid

Maintenance is where most projects fail. A sediment basin is a living system that changes with every storm.

Cleaning Frequency and Sediment Removal

You should never let a basin fill up completely. The standard rule is to remove sediment when it reaches one-third to one-half of the storage capacity.

  • Capacity Monitoring: We install "cleanout stakes" — essentially giant rulers in the mud — that show exactly how deep the sediment is.
  • Dredging: Once the limit is hit, we use an excavator to muck out the basin. This sediment must be disposed of in a stable upland area where it won't just wash right back in.
  • Logbooks: FDEP requires you to keep an inspection log. If an inspector walks onto your site and you don't have a record of your weekly checks, you're looking at a violation.

Preventing Common Installation Mistakes

  1. Short-Circuiting: This happens when the inlet and outlet are too close together. The water just "skips" across the top without settling. Baffles are the cure for this.
  2. Poor Compaction: If the dam isn't compacted, it will "pipe" and eventually blow out, sending a wall of mud downstream.
  3. Delayed Stabilization: Waiting weeks to seed the basin slopes is a recipe for disaster.
  4. Improper Inspection: Not checking the basin after a 0.5-inch rain event. In Florida, that can happen three times a week!

Frequently Asked Questions about Florida Sediment Basins

How does a sediment basin differ from a catch basin?

A sediment basin is a large, engineered pond designed to hold water for days to let fine silt settle. A catch basin is a small inlet box designed for immediate drainage of surface water and trapping large debris like trash.

When is a sediment basin required on a Florida construction site?

Under the FDEP Construction General Permit, any site disturbing 10 or more acres that drains to a single point generally requires a sediment basin. Many smaller sites (5+ acres) also utilize them to meet the 80% TSS removal requirement.

How often should sediment be removed from the basin?

Sediment should be removed whenever it reaches one-third to one-half of the basin's design volume. Additionally, the basin should be inspected weekly and within 24 hours of any rain event greater than 0.5 inches.

Conclusion

At Foshee Construction Co., Inc., we know that sediment basin installation fl is about more than just moving dirt — it’s about protecting your investment and Florida’s natural beauty. Based in Minneola, we’ve built our reputation on transparent bids, disciplined scheduling, and a "safety first" mentality that keeps your project on track and in compliance.

Whether you are starting a new residential development in Lake County or a large-scale commercial project, our team has the expertise to handle everything from initial site prep and underground utilities to complex erosion control systems.

Don't leave your site compliance to chance. If you need reliable, expert site preparation and erosion control, visit us at Foshee Construction to learn how we can help you ground your project in success.
