A Complete Beginner Guide to Using Riprap for Soil Erosion Control

Learn what is rip rap erosion control, how it works, and key design specs for permanent shoreline and channel protection.

What Is Rip Rap Erosion Control?

What is rip rap erosion control? It is a layer of large, durable, angular stones placed over prepared soil, usually with a filter fabric or gravel layer underneath, to protect slopes, shorelines, ditches, and drainage outlets from erosion and scour caused by flowing water or waves.

Riprap works by slowing and spreading the force of water. The uneven stones absorb energy that might otherwise wash soil away, helping protect nearby roads, utilities, detention ponds, and building pads.

For Florida contractors and developers, riprap is often used where runoff is too strong for grass or other vegetation to hold the soil in place. It is a durable solution, but it must be properly designed for the site's water velocity, soil conditions, slope, and drainage pattern.

I am Don Larsen of Foshee Construction Co., Inc., and I have worked in Central Florida site development, grading, excavation, and erosion-control work since 1994. Understanding what is rip rap erosion control helps project teams choose the right protection before runoff creates costly site damage or schedule delays.

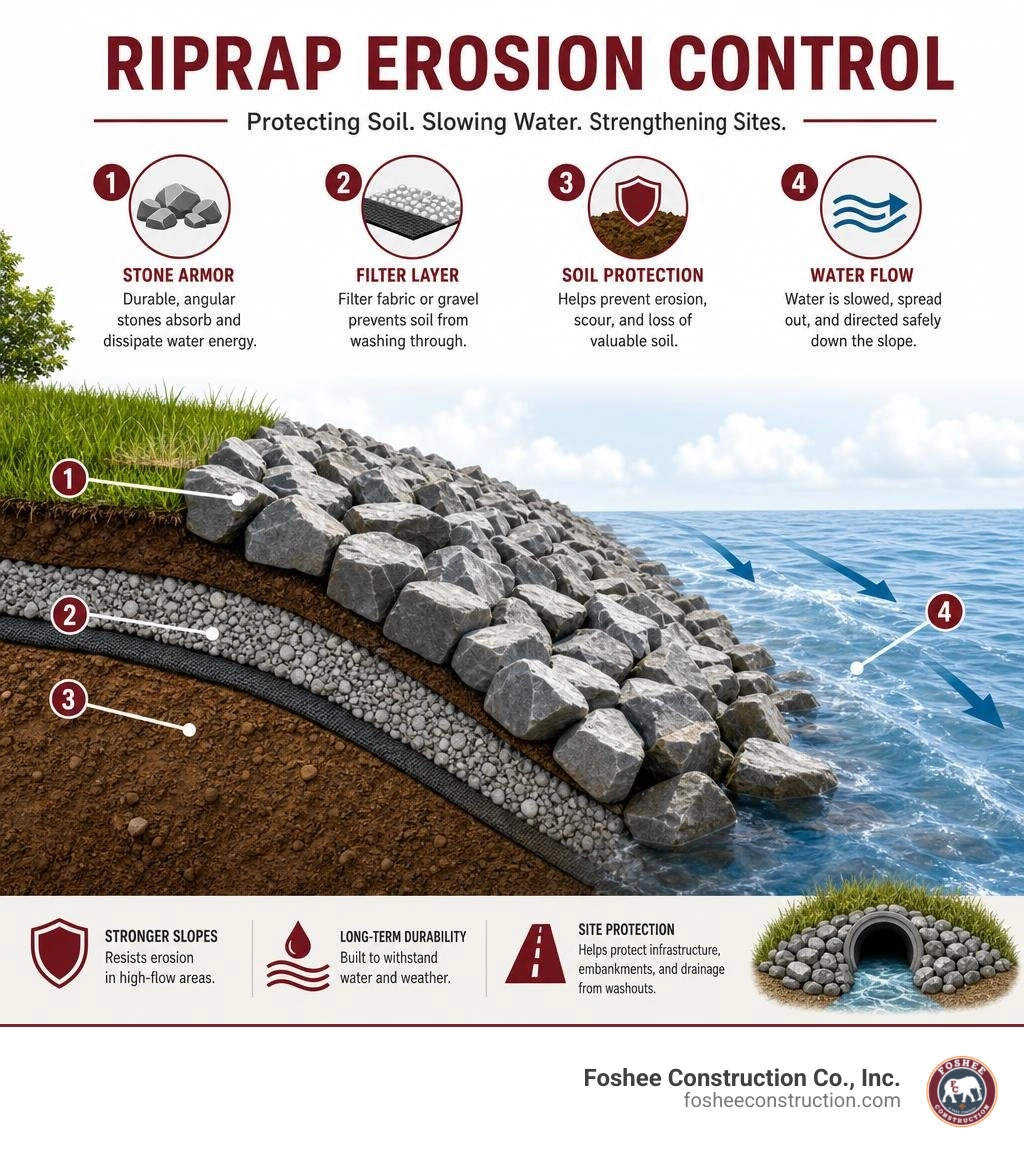

Riprap erosion control showing stone armor, filter layer, soil protection, and water flow infographic

Understanding What Is Rip Rap Erosion Control and How It Works

When water moves rapidly over exposed soil, it creates shear stress—a mechanical dragging force that breaks down topsoil, cuts deep gullies, and washes away embankments. In civil engineering and site development, understanding what is rip rap erosion control boils down to understanding physical resistance and energy dissipation.

Rather than allowing high-velocity water to strip sandy Florida subsoil directly, we install a interlocking mass of dense, angular rock. The irregular surface profile of a riprap blanket significantly increases surface roughness. As concentrated stormwater runoff hits the jagged stone field, the fluid energy turns into turbulent eddies within the rock voids. This drastically reduces the water’s flow velocity, neutralizing its ability to scour the soil surface.

According to the EPA Stormwater Best Management Practice guidelines, riprap acts as a permanent soil armor that absorbs hydraulic energy in areas of concentrated flow or wave action. By slowing down runoff before it enters downstream stormwater systems, detention basins, or natural waterways, riprap prevents structural undermining and keeps surrounding site grades stable.

Defining What Is Rip Rap Erosion Control in Construction

In everyday site development, riprap is far more than just "dumping rocks down a hill." It is a precise engineering system requiring hard, durable stone mixtures (typically granitic or heavy igneous rock) that resist degradation from moisture, weathering, and mechanical impact.

To function properly, stone selection relies on specific rock gradations rather than uniform stone sizes. A well-graded mixture includes large anchor stones, medium filler stones, and smaller aggregate that fit tightly into the open gaps. This natural interlocking effect prevents individual rocks from sliding or being swept downstream.

As a primary structural erosion control measure, riprap must maintain a minimum rock specific gravity of 2.5 to ensure the material is dense enough to remain anchored during flash floods and heavy storm surges.

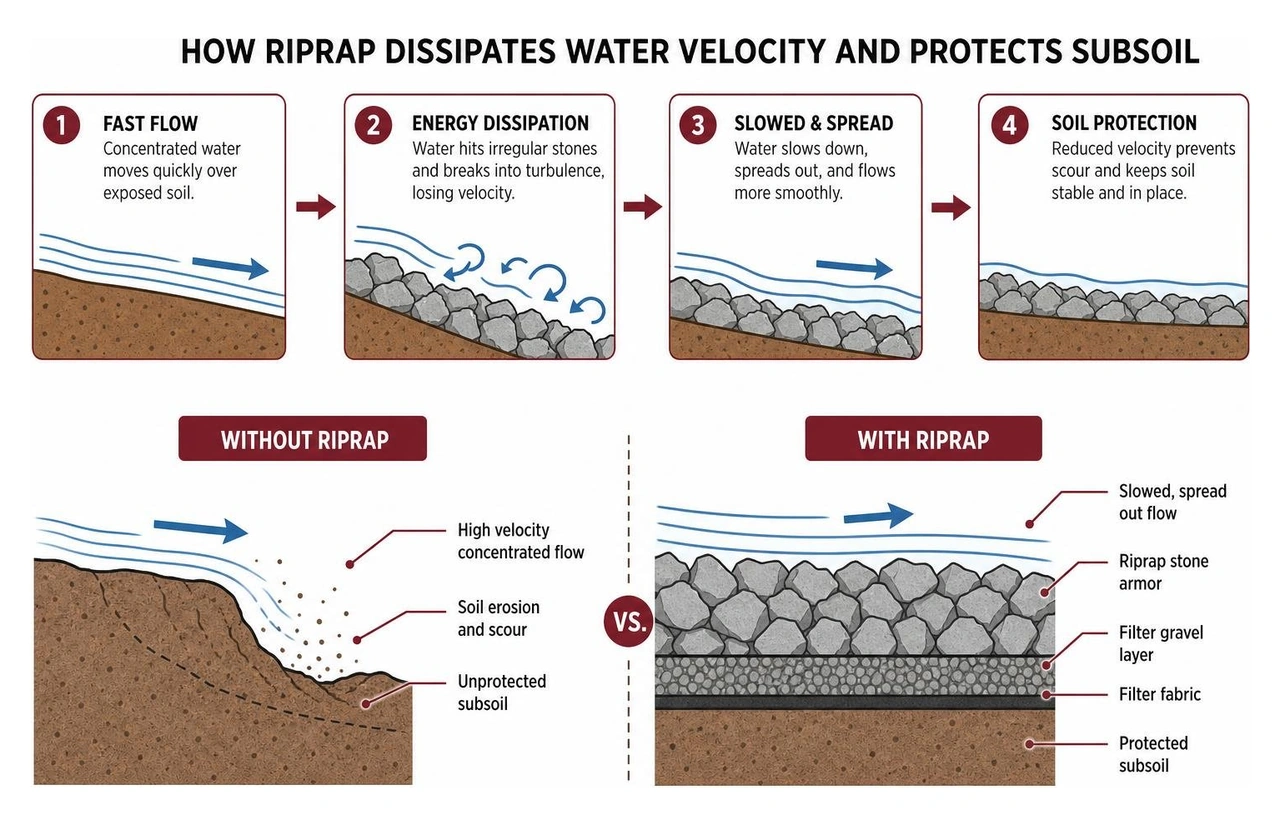

How riprap dissipates water velocity and protects subsoil

Primary Applications for What Is Rip Rap Erosion Control

We utilize riprap across high-erosion impact areas on Central Florida job sites, including:

  • Channel Linings and Drainage Ditches: Lining high-gradient swales and storm channels where shear stress exceeds what natural turfgrass or erosion mats can handle.
  • Culvert Inlets and Outlets: Forming energy dissipation aprons at pipe discharges where high-velocity water discharges threaten to cut deep plunge pools into the ground.
  • Shoreline and Retention Pond Armoring: Shielding lake banks and stormwater pond slopes from destructive wind-driven wave action.
  • Bridge Abutments and Culvert Crossing Walls: Armoring critical transportation embankments adjacent to active water channels to safeguard foundations against catastrophic erosion.
  • Temporary and Permanent Check Dams: Constructing permeable rock berms inside active drainage paths to trap sediment while allowing filtered stormwater to pass through safely.

Key Design Criteria and Installation Specifications

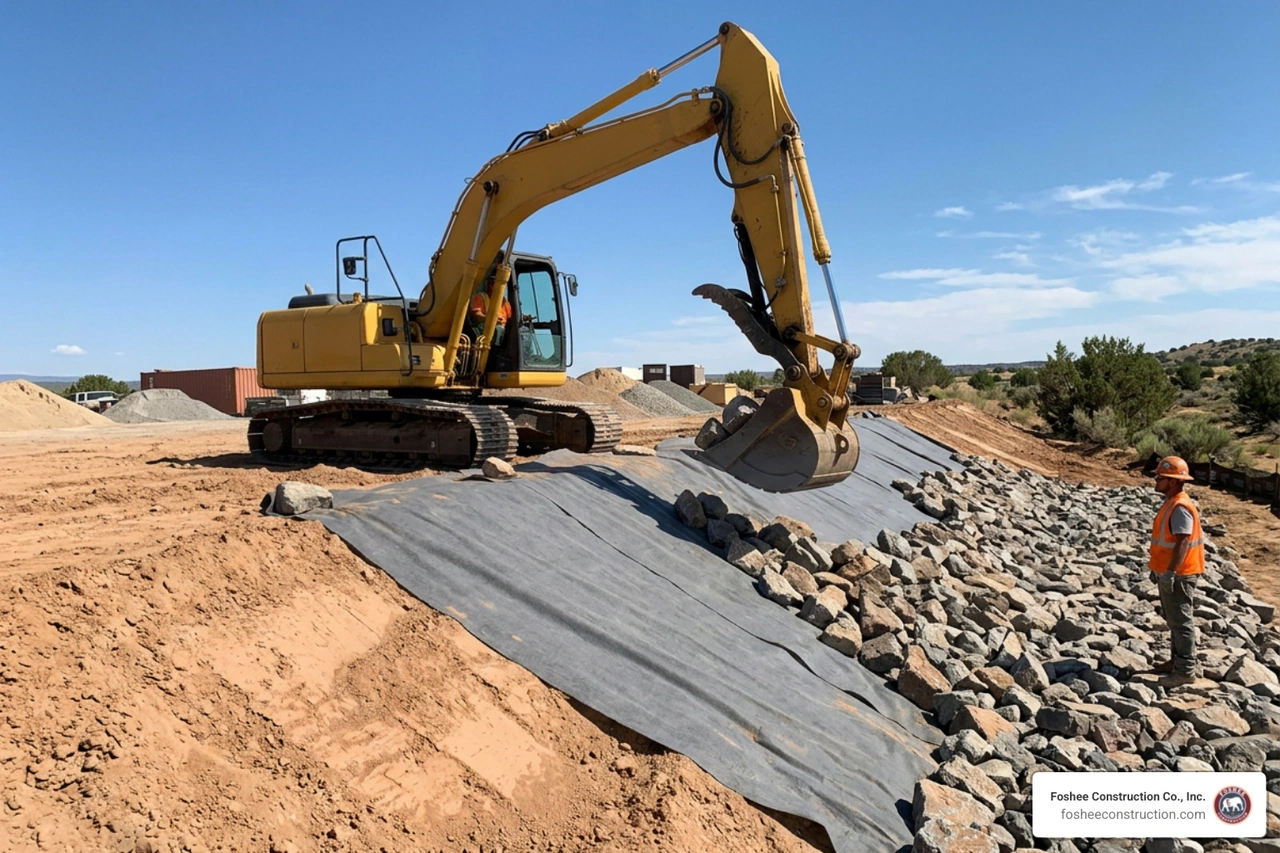

Riprap installation showing excavators placing rock on filter cloth

A riprap revetment is only as reliable as its underlying design engineering. Laying stone haphazardly without analyzing site hydraulics or slope mechanics usually ends in total structural failure during the first heavy rainfall.

Rock Sizing and Velocity Specifications

Selecting the correct stone size depends entirely on maximum anticipated flow velocities. Engineers calculate the median rock diameter, known as $D_{50}$, which represents the stone size where 50% of the rock mixture by weight is smaller and 50% is larger.

As water speed increases, the size and weight of required stone escalate rapidly to counteract hydrodynamic lift and drag forces:

Flow Velocity (ft/s)Minimum $D_{50}$ Stone SizeMaximum Rock Size ($D_{max}$)Recommended Application
5.0 ft/sec4 inches6 inchesLow-flow swales, small ditch bottoms
8.5 ft/sec8 inches12 inchesRetention pond inlets, moderate channels
10.0 ft/sec12 inches18 inchesHigh-volume culvert outfalls, pond shorelines
12.0 ft/sec16 inches24 inchesSteep drainage channels, stream banks
15.0 ft/sec+24 inches36 inchesHeavy river bends, high-velocity discharge structures

Adhering to Federal Highway Administration Guidelines (HEC-11) ensures the layer thickness is designed to at least 1.5 times the maximum stone diameter ($1.5 \times D_{max}$) or a strict absolute minimum layer depth of 6 inches.

Underlayment and Filter Fabric Requirements

A major mistake in DIY or poorly executed contractor installations is placing rock directly over raw soil. When water surges through the voids of a riprap layer, it creates suction and turbulence that draws fine subsoil particles out through the rock voids. This process, known as soil piping, slowly undermines the rocks until the whole structure collapses into a sunken pit.

To prevent piping, we always install a geotextile underlayment fabric or a graded aggregate granular filter blanket beneath the riprap layer. For heavy riprap, a needle-punched non-woven geotextile fabric (ranging from 8 oz to 16 oz per square yard) acts as a tough, permeable barrier. It holds subsoil particles in place while allowing groundwater pressure to vent freely.

Key geotextile installation protocols include:

  • Subgrade Preparation: Clearing all roots, debris, and sharp rocks before compacting the subgrade soil smoothly.
  • Overlap Rules: Overlapping fabric edges by at least 1.5 to 2.0 feet, always shingling the top sheet over the bottom sheet in the direction of water flow.
  • Securing Pins: Pinning fabric down every 3 feet along seams and burying the upstream/top edges in a 12-inch deep anchor trench.
  • Prompt Covering: Covering geotextile fabric with stone as soon as possible—and no later than 7 days post-placement—to avoid ultra-violet light degradation.

This essential step ensures long-term protection on erosion prevention construction sites.

Slope Limitations and Placement Technique

Slope gradient plays an essential role in structural stability. Riprap is not recommended for slopes steeper than 2:1 (2 feet horizontal to 1 foot vertical). On slopes exceeding 2:1, gravity works against rock interlock, causing loose boulders to roll, slide, or slump downward during rainstorms.

Proper stone placement steps require experienced equipment operators:

  1. Toe Keying: Digging a toe trench at the base of the slope at least 2 feet deep and extending 3 feet horizontally to securely lock the bottom anchor stones into place.
  2. Mechanical Placement: Placing rock carefully using excavators, loaders, or specialized grapple buckets. Rocks must never be end-dumped down long embankments from dump trucks, as this causes severe material segregation where heavy rocks bounce to the bottom while fine rock remains at the top.
  3. Low Drop Height: Dropping stones onto bare geotextile fabric from a height of no more than 1 foot to prevent tearing or puncturing the underlying cloth (unless cushioned by a 6-inch sand/gravel cushion).
  4. Bottom-to-Top Construction: Placing rocks starting at the bottom toe key excavation and working upward along the slope.

Pros, Cons, and Environmental Considerations

Like any engineering solution, riprap has distinct trade-offs that project managers must weigh against alternative earthwork measures.

Key Benefits and Cost Breakdown

Pros:

  • Extreme Longevity: Once installed correctly, stone riprap provides virtually permanent, zero-decay armor against heavy hydraulic forces.
  • Flexible Structure: Unlike rigid concrete slabs, loose rock revetments adjust naturally to subtle ground settling without cracking or losing performance.
  • Simple Repair: Individual dislodged stones can be replaced easily without demolishing the whole installation.

Cons:

  • High Upfront Material Costs: Sourcing, hauling, and placing thousands of pounds of high-density rock is significantly more expensive than hydroseeding or installing rolled blankets.
  • Heavy Machinery Requirements: Requires excavators, dump trucks, and skilled operators.
  • Harsh Aesthetic: Replaces natural green vegetation with a stark, industrial rock face.

When budgeting for erosion control rip rap, costs vary widely based on placement style, stone availability, and transportation distance:

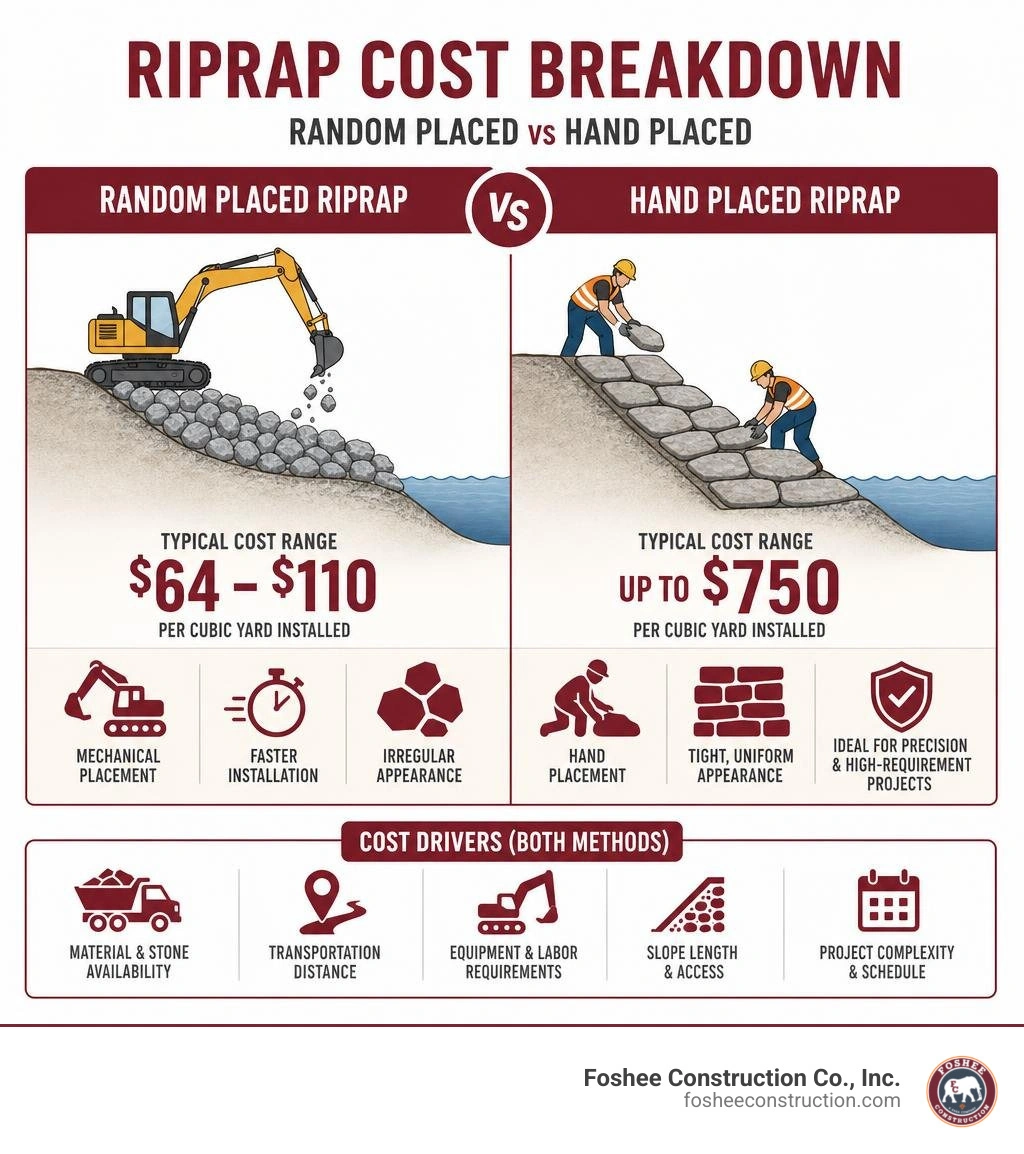

Cost breakdown comparison between random placed riprap vs hand placed riprap infographic

  • Random Placement Riprap: Typical cost ranges from $64 to $110 per cubic yard installed. Rocks are mechanically placed and smoothed using heavy excavators.
  • Hand-Placed Riprap: Cost ranges up to $750 per cubic yard installed. Requires manual laborers to fit flat-faced stones together tightly like a stone wall, reserved for tight urban areas, historic shorelines, or precise bridge abutments.

Ecological Impacts and Maintenance Standards

While riprap excels at soil stabilization, it introduces clear environmental modifications:

  • Thermal Alteration: Dark granite or basalt rocks absorb direct solar heat and reflect thermal radiation into adjacent water bodies, raising water temperatures and lowering dissolved oxygen levels for local aquatic life.
  • Habitat Disruption: Removing native shoreline trees eliminates shade and natural wood debris. However, spaces between large submerged boulders can occasionally offer micro-habitats for small aquatic organisms.
  • Wildlife Barriers: Jagged rock embankments can block safe passage for small terrestrial animals attempting to reach the water’s edge. Where wildlife corridors are needed, we can construct smooth "passage benches" topped with topsoil, compost, and small gravel across sections of the riprap slope.

Routine Maintenance Practices:

  • Conduct visual inspections annually and immediately after tropical storms or heavy rainfall events.
  • Check for dislodged rock, localized slumping, or exposed filter fabric.
  • Clear trapped trash, floating timber, or excessive woody brush that could clog flow paths or displace rocks.

Comparing Riprap to Alternative Erosion Control Methods

Choosing between hard armoring and soft bioengineering depends on water velocity, project longevity goals, site aesthetics, and budget constraints.

Feature / MethodRiprap Rock ArmorRolled Erosion Control Blankets (RECPs)High-Performance Turf Mats (HPTRM)Vegetated Bioengineering
Primary MaterialHeavy angular rock / graniteStraw, coconut coir, or jute matrixSynthetic UV-stabilized woven matrixNative plants, live stakes, willow bundles
Erosion ResistanceExtremely High (Flows > 15 ft/s)Low to Moderate (Flows < 6 ft/s)High (Flows up to 10-12 ft/s)Moderate (Flows < 8 ft/s)
System FlexibilityHigh (adjusts to settling)High (conforms to ground)High (anchored to soil)High (dynamic root network)
Relative CostHigh ($64–$750 / cu yd)Low ($2–$5 / sq yd)Moderate (~25% of riprap total cost)Moderate ($5–$15 / sq yd)
Environmental FootprintHard visual impact; elevates water tempsBiodegradable / natural integrationSoft visual integration once grass growsRestores riparian zone & native habitats

Rolled Products vs Heavy Hard Armor

Rolled products offer flexible, low-cost alternatives for low-energy slopes and swales:

  • Temporary installations often rely on a natural erosion control blanket made of agricultural straw or coconut fibers.
  • For higher flow channels that do not quite demand heavy boulders, choosing a dense coir blanket erosion control matting holds soil intact while vegetation establishes its root structure.
  • Following a proper erosion control blanket installation guide ensures these lighter products remain pinned flush against subgrade soil without wind or sheet-flow lift.

Where shear forces exceed 10–12 feet per second, soft rolled products wash away, making structural riprap or concrete mats necessary.

Vegetative Solutions and Bioengineering

For project owners seeking eco-friendly alternatives, bioengineering methods blend mechanical soil stabilization with living plant biology:

  • Reviewing an erosion control plants ultimate guide helps site managers select deep-rooting grasses, wetland rushes, and native shrubs.
  • Live Staking: Inserting dormant woody cuttings (like willow or buttonbush) into soft shoreline banks to form root networks that bind soil together naturally.
  • Vegetated Riprap (Hybrid approach): Combining angular stone with topsoil and live plantings inserted directly into the rock spaces. The roots bind the underlying soil while green foliage softens the harsh industrial visual appearance.

Frequently Asked Questions About Riprap Erosion Control

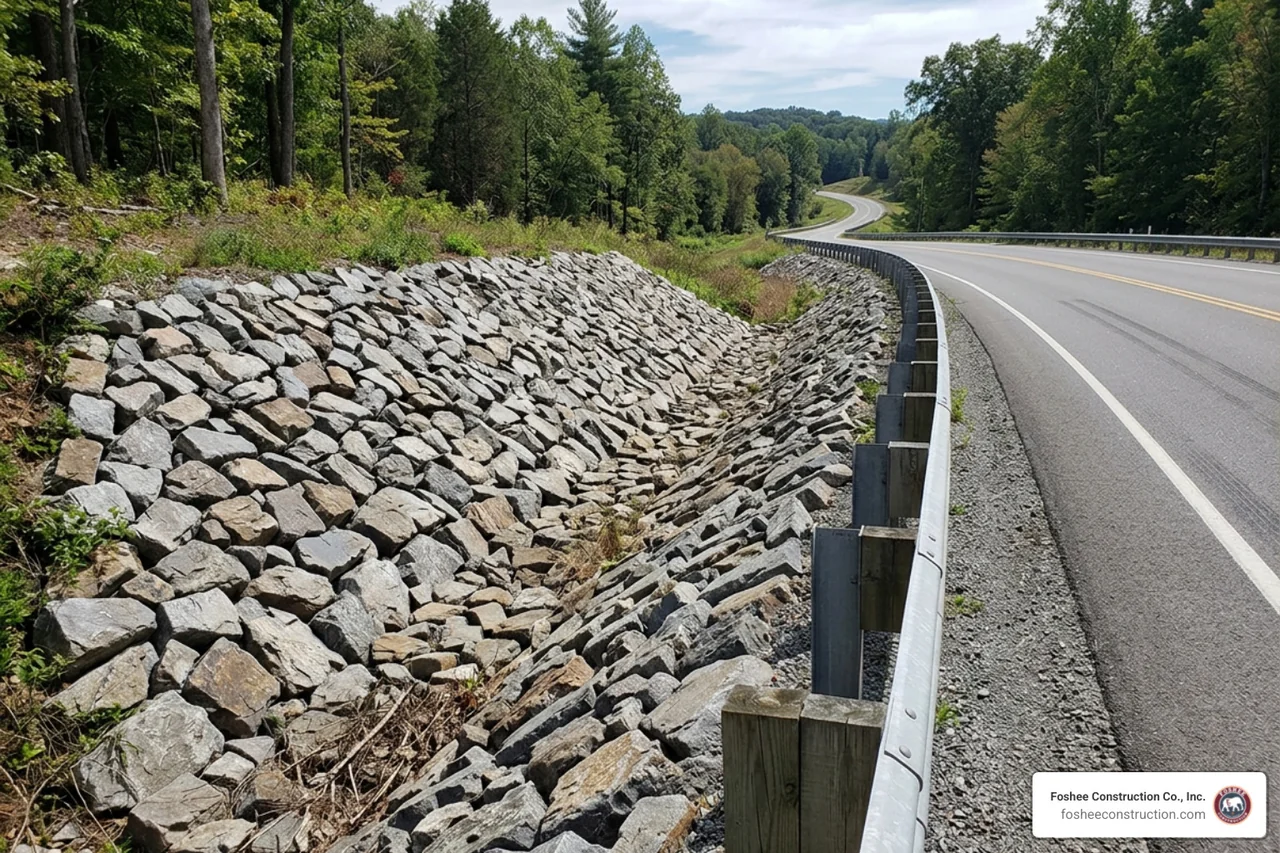

Riprap ditch lining protecting a roadway edge

The standard maximum recommended slope ratio for riprap placement is 2:1 (horizontal to vertical), which is approximately a 26.5-degree angle. On slopes steeper than 2:1, gravity causes stones to become unstable, leading to downhill slumping, rolling rocks, and structural collapse.

If your site features slopes steeper than 2:1, you should consider alternatives like wire-enclosed gabion baskets, articulated concrete block mats, or structural retaining walls.

How much does riprap installation cost per cubic yard?

Installed costs generally range from $64 to $110 per cubic yard for standard random-placed riprap using heavy machinery.

If your project requires hand-placed, tightly fitted riprap in restricted access areas, costs can increase up to $750 per cubic yard due to heavy manual labor demands. Overall expenses depend on local stone availability, freight distance, total site yardage, subgrade prep, and geotextile underlayment selection.

Why is geotextile filter fabric required under riprap?

Geotextile filter fabric forms a vital separation layer between raw soil and stone cover. Without geotextile fabric, flowing water pulls fine soil particles up through the voids between rocks (soil piping). Over time, this erodes the underlying base, causing the heavy riprap stones to sink into the mud and lose structural stability.

A needle-punched non-woven geotextile fabric allows groundwater to drain freely while holding subsoil firmly in place.

Conclusion

Understanding what is rip rap erosion control is essential for any land developer, general contractor, or site owner facing severe washouts, steep channel flows, or shoreline deterioration. When designed with correct rock sizing, robust geotextile underlayment, and proper toe-keying techniques, riprap provides an extremely reliable defense against severe soil erosion.

At Foshee Construction Co., Inc., we bring decades of hands-on earthwork, grading, and site preparation experience to every project across Minneola, Lake County, and Central Florida. Whether you need initial site clearing, stormwater pond shaping, or heavy-duty erosion control rip rap solutions, our team delivers transparent bids, disciplined project scheduling, and unyielding site safety standards.

Have an active site development project or an erosion issue on your property? Reach out to Foshee Construction Co., Inc. today to discuss your site plans and build a long-lasting erosion control strategy.
